Mountain View Ground Floor Room Addition Contractor Guide: Costs, Permits, and Zoning Rules

Building a ground-floor room addition in Mountain View, California, costs between $350 and $800 per square foot, with total project budgets typically ranging from $120,000 for a minor bump-out expansion to over $600,000 for a luxury ground-floor master suite or great room addition. Planning and municipal permitting through the City of Mountain View Development Services takes between 3 and 8 months, while physical construction requires an additional 4 to 7 months. Success requires navigating strict local Floor Area Ratio (FAR) caps, minimum setback rules, Title 24 energy calculations, and CALGreen compliance. Homeowners hiring a licensed general contractor like LeCut Construction gain a streamlined design-build process that handles architectural drafting, engineering, city reviews, and foundation-to-finish execution.

Key Takeaways for Mountain View Homeowners

  • Average Square-Foot Cost: Ground-floor room additions in Mountain View average $400 to $750 per square foot, depending on soil conditions, plumbing fixtures, and structural tie-ins.

  • City Permitting Timeline: Plan review and completeness checks by the Mountain View Building and Planning Divisions require 3 to 8 months prior to ground breaking.

  • Zoning & FAR Limits: Residential R1 lots under 5,000 sq ft have a maximum base Floor Area Ratio (FAR) of 0.45, while larger lots utilize a scaled formula down to 0.40 FAR.

  • Setback Mandates: First-story front setbacks require a minimum of 20 feet, side setbacks require a minimum of 5 feet (with 10 to 12 feet combined total across both sides), and rear setbacks require 20% of lot depth or 15 feet.

  • Energy & Environmental Standards: All residential additions must meet California Title 24 Building Energy Efficiency Standards and CALGreen waste diversion mandates.

Mountain View Zoning, FAR, and Building Regulations

Navigating city regulations is the most critical pre-construction phase for any ground-floor expansion. The City of Mountain View enforces clear zoning standards under Chapter 36 of the Municipal Code to manage neighborhood density and structural footprint.

Maximum Allowed Floor Area Ratio (FAR) Formula: FAR = 0.50 – (0.00001 * Lot Area)

Floor Area Ratio (FAR) Limits

  • Lots 5,000 sq ft or less: Maximum base FAR is 0.45 (e.g., a 4,500 sq ft lot allows up to 2,025 sq ft of total habitable floor space).

  • Lots 5,001 sq ft to 9,999 sq ft: Calculated via the formula $FAR = 0.50 – (0.00001 times text{Lot Area})$.

  • Lots 10,000 sq ft or greater: Maximum base FAR caps at 0.40.

Ground-Floor Setback Requirements

  • Front Yard Setback: Minimum of 20 feet measured from the front property line to the first-floor wall.

  • First-Story Side Yard Setback: Minimum of 5 feet on any single side. For lots under 6,000 sq ft, the combined total side setback across both sides must equal at least 10 feet. For lots 6,000 sq ft or greater, the combined side setback must equal at least 12 feet.

  • First-Story Rear Yard Setback: Must equal 20% of the total lot depth or 15 feet, whichever is greater (capped at a maximum 40-foot requirement).

  • Height & Plate Limits: Single-story structural additions are capped at a overall maximum height of 24 feet, with a maximum top-of-wall plate height of 15 feet.

Detailed Cost Breakdown for Mountain View Ground-Floor Additions

Ground-floor additions involve foundation excavation, concrete footings, framing, roof tying, structural shear wall integration, electrical work, plumbing, and HVAC extensions. High labor rates and material costs in Silicon Valley make detailed budgeting essential.

Addition Type Average Square Footage Cost Range Per Sq Ft Estimated Total Cost Common Included Features
Micro Bump-Out / Bathroom Expansion 50 – 150 sq ft $500 – $800 $35,000 – $120,000 Cantilevered or slab foundation, plumbing line extensions, high-end tile, expanded vanity
Ground-Floor Master Bedroom Suite 350 – 600 sq ft $450 – $700 $160,000 – $420,000 Perimeter foundation, walk-in closet, full ensuite bath, dedicated heat pump ducting
Kitchen & Family Great Room Extension 400 – 800 sq ft $500 – $850 $200,000 – $680,000 Load-bearing beam removal, island plumbing, gas lines, high-efficiency sliding glass walls
Multi-Generational Living Suite 500 – 1,000 sq ft $425 – $675 $215,000 – $675,000 Separate exterior door, private bath, living room, independent subpanel, Title 24 HVAC zone

Cost Factors Specific to Mountain View Homes

  • Foundation Deepening & Geotechnical Conditions: Clay soils in portions of Mountain View require continuous concrete footings or deep pier foundations to prevent settling.

  • Geotechnical Reports: Additions exceeding 1,200 square feet automatically trigger a mandatory soil and geotechnical engineering study under Santa Clara County and local building guidelines.

  • Property Surveys: Any addition built within 6 feet of a property line or minimum setback line requires a certified site survey by a licensed land surveyor prior to pouring concrete footings.

  • Utility Service Upgrades: Upgrading electrical service from older 100-amp panels to 200-amp or 400-amp service panels is standard when adding square footage and electric HVAC systems.

Ground-Floor Addition vs. Second-Story Addition Comparison

Choosing between expanding your home’s footprint on the ground floor or building upward involves trade-offs in structural engineering, cost, lifestyle disruption, and neighborhood approval.

Evaluation Metric Ground-Floor Room Addition Second-Story Addition
Average Cost Range $350 – $800 per sq ft $550 – $1,000 per sq ft
Foundation Impact Requires new trenching, footings, and slab or raised foundation pour Requires underpinning and retrofitting existing ground-floor foundations
Living Disruption Low to Moderate; homeowners can often live inside the home during construction High; roof removal usually forces temporary relocation for 6 to 10 months
Mountain View Setback Rules Standard first-story setbacks (5 ft side / 15-20 ft rear) Stricter second-story side setbacks (7-12 ft) and privacy design review
Yard Space Preservation Consumes ground-level lot area and green space Preserves existing yard footprint and open yard space
Accessibility 100% aging-in-place friendly with zero stair barriers Requires space for staircases (losing ~50-80 sq ft on ground level)

Step-by-Step Construction and Permitting Roadmap

Expanding a home in Mountain View follows a structured legal and physical sequence. Skiping steps or initiating unpermitted work can lead to City stop-work orders and costly re-engineering.

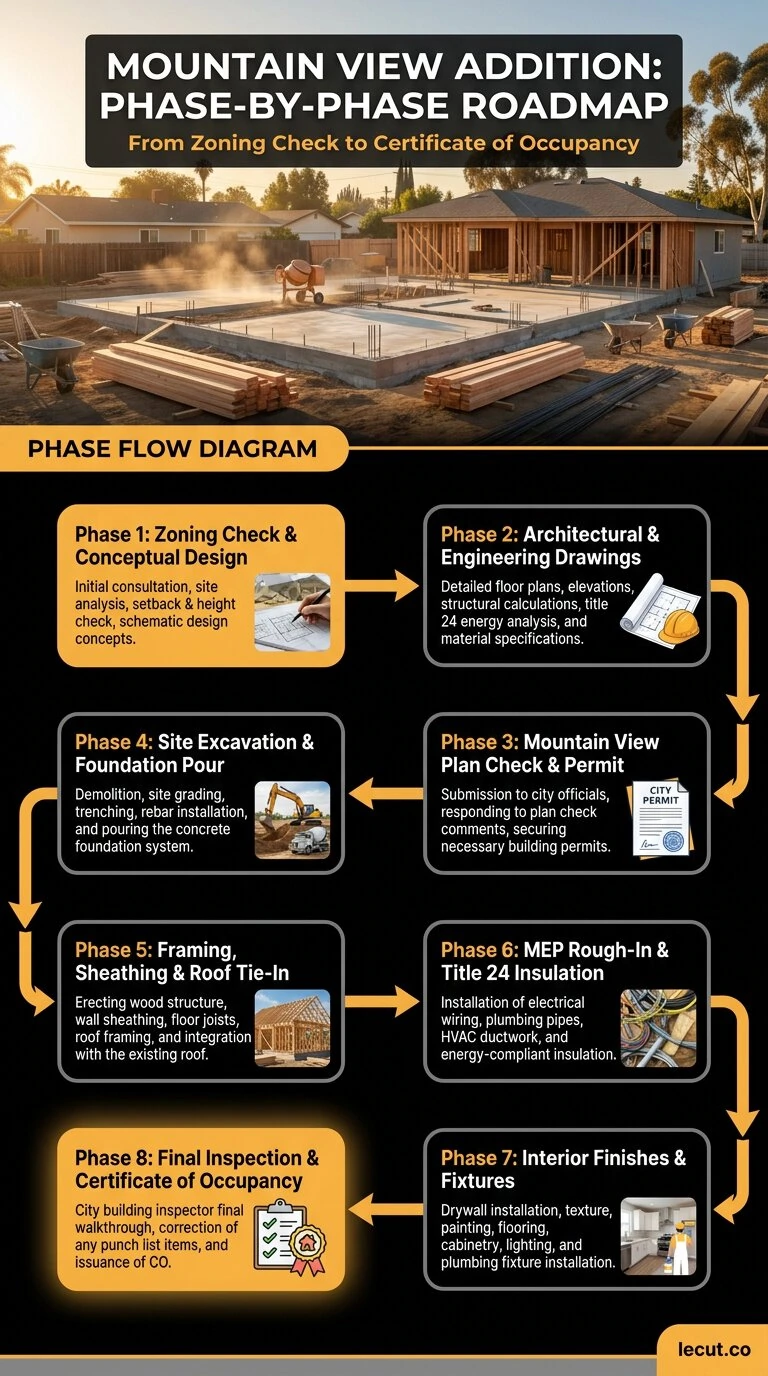

Construction and Permitting Roadmap-lecut

Phase 1: Pre-Design & Feasibility Analysis

  • Review property boundary lines, lot coverage history, and underlying zoning district parameters.

  • Consult with the Mountain View Development Services Building Division to confirm maximum FAR availability.

  • Conduct an initial site evaluation to identify sewer lines, gas main tie-ins, and heritage trees subject to municipal tree protection ordinances.

Phase 2: Architectural, Structural, and Title 24 Engineering

  • Draft complete architectural plan sets including floor layouts, structural elevations, foundation cross-sections, and roof framing plans.

  • Perform structural load calculations for shear walls, hold-downs, and beam headers over openings.

  • Prepare mandatory Title 24 energy compliance documentation confirming wall insulation ratings (R-21+), ceiling insulation (R-38+), and high-performance fenestration (U-factor $le 0.30$).

Phase 3: Permit Application and City Plan Check Review

  • Submit digital plan sets through the Mountain View online permit portal.

  • Completeness Review: City staff verifies all application documents within a 3-week window.

  • Compliance Review: Initial code and plan review takes 4 weeks. Subsequent revision reviews take 2 weeks per cycle.

  • Secure specialized sub-permits where required, including demolition permits, fire sprinkler modification permits, and public right-of-way excavation permits. Verify contractor licensing and workers’ compensation coverage through the California Contractors State License Board (CSLB).

Phase 4: Foundation, Framing, and Building Envelope Construction

  • Excavate trenches for perimeter stem walls or continuous footings.

  • Pass mandatory City foundation inspection prior to pouring concrete.

  • Frame exterior wood stud walls, floor joists, roof trusses, and plywood shear paneling.

  • Install weather-resistive barriers, flashing, energy-efficient windows, and roofing materials to enclose the structure.

Phase 5: Rough Trades, Insulation, Drywall, and Finishes

  • Install mechanical ductwork, plumbing supply/waste lines, and electrical wiring.

  • Complete mandatory City trade rough-in inspections before covering wall cavities.

  • Install Title 24 compliant thermal insulation meeting California Energy Commission mandates.

  • Hang drywall, apply texture, install flooring, trim, cabinetry, and final plumbing and lighting fixtures.

  • Pass final municipal inspections to receive the Certificate of Occupancy.

Detailed Infographic Breakdown: Ground-Floor Addition Planning Blueprint

This section provides visual layout specifications and structural data for an infographic illustrating a ground-floor room addition in Mountain View.

Visual Layout and Section Design

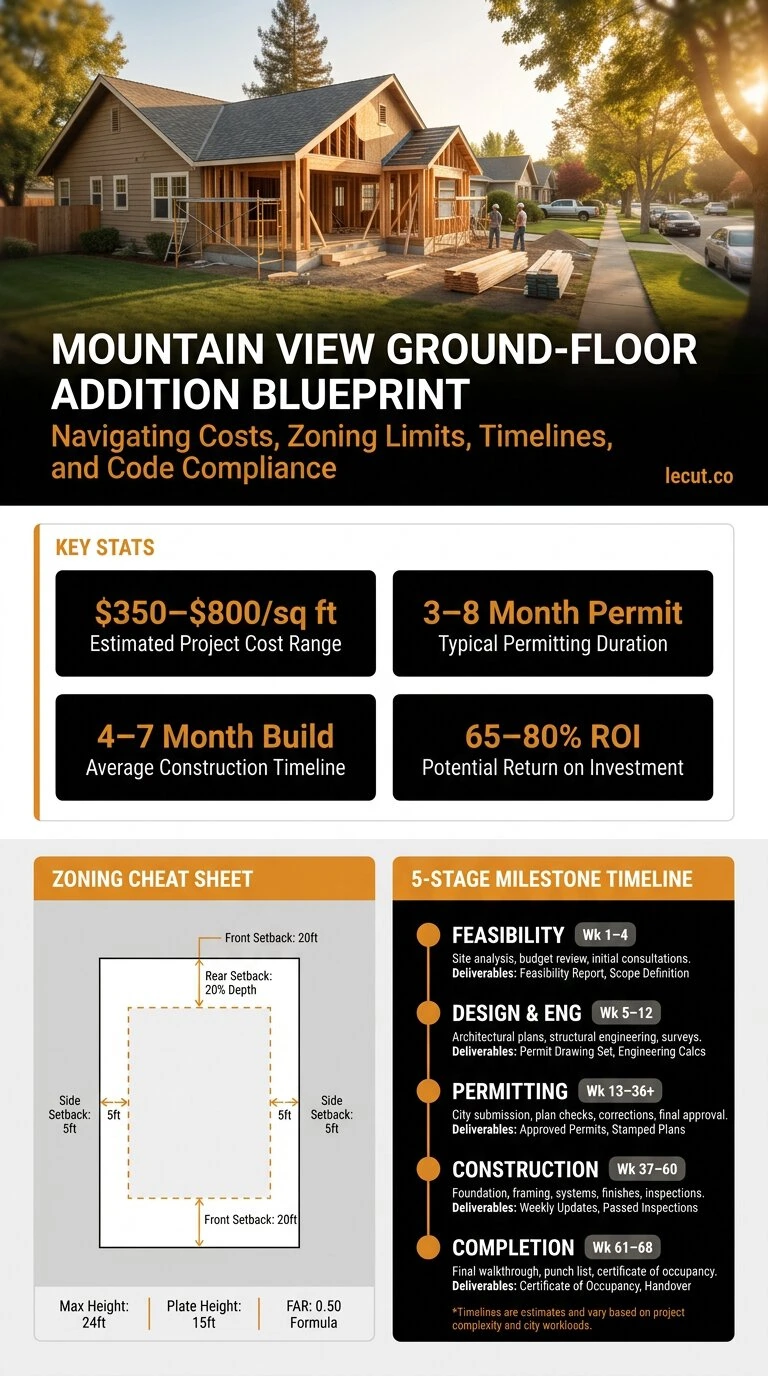

mountain view ground-floor addition blueprint

Frequently Asked Questions

How long does it take to get a permit for a room addition in Mountain View?

Permit processing in Mountain View takes between 3 and 8 months. The initial completeness review requires 3 weeks. Once verified, the primary code compliance review takes 4 weeks. If the city requires plan corrections, each resubmittal review cycle takes an additional 2 weeks.

What is the maximum allowed floor area for an addition on an R1 lot?

The maximum size depends on your lot square footage and existing home footprint under the City’s Floor Area Ratio (FAR) rules. For lots under 5,000 sq ft, overall home square footage cannot exceed 45% of the total lot size. For lots between 5,001 and 9,999 sq ft, maximum FAR is calculated using the formula $FAR = 0.50 – (0.00001 times text{Lot Area})$.

Can I build a ground-floor room addition right up to my property line?

No. First-story additions must maintain a minimum 20-foot front setback, a minimum 5-foot side setback (with a combined 10 to 12 feet across both side yards), and a rear setback of 20% of the lot depth or 15 feet, whichever is greater.

Does a ground-floor addition require fire sprinklers?

If your existing main dwelling already has fire sprinklers, or if the scope of the addition and major remodel triggers whole-house fire system upgrades under current California Residential Code thresholds, fire sprinklers must be installed throughout the new addition.

How does Title 24 affect my room addition budget?

California Title 24 energy codes require room additions to meet strict efficiency standards. This includes high-efficiency wall and ceiling insulation, dual-pane low-E windows, controlled LED lighting, and high-efficiency HVAC equipment. While adding 5% to 10% to initial material costs, it significantly reduces ongoing heating and cooling expenses.
